It’s been about a month since my capstone project officially commenced, so here’s a quick summary of what’s taken place since then and what’s ahead. I’ll use a “progress, plans, problems” structure for these updates.
Progress

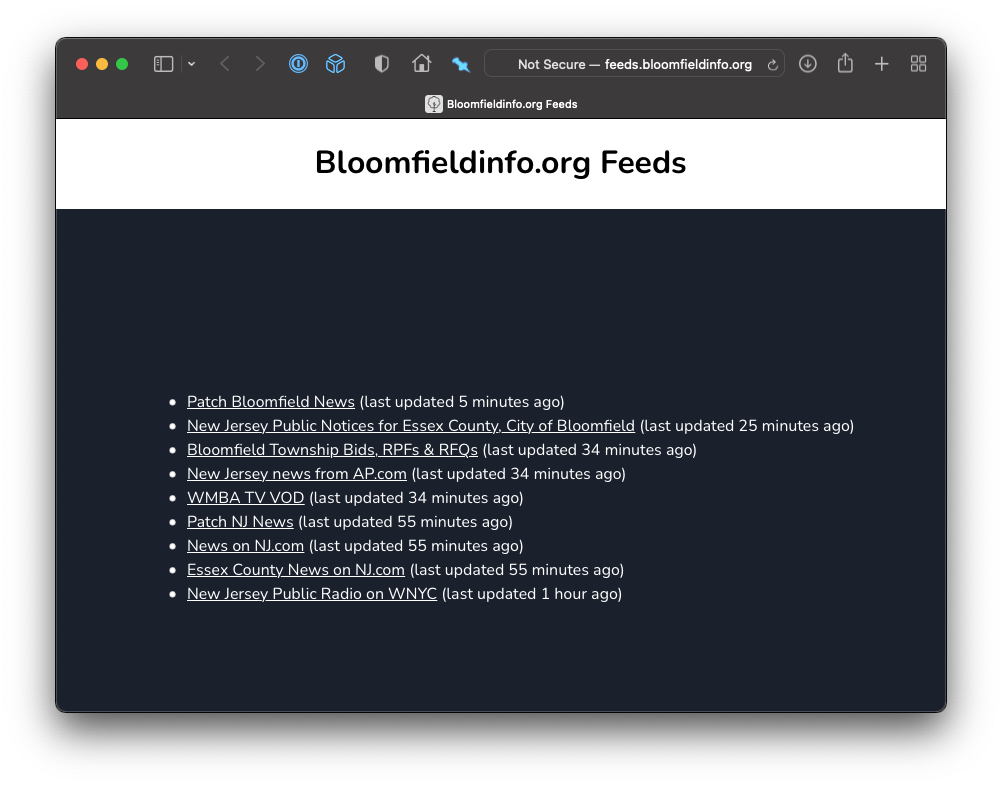

- I set up this project website and posted my capstone project proposal, background information, planned deliverables (with feedback from the capstone committee incorporated) and a project timeline.
- I documented some of the “side projects” that I have worked on for the Bloomfield Information Project related to the overall goals of my project.
- I proposed and reviewed with Dr. Blom a list of questions for stakeholder interviews.
- I’ve conducted three stakeholder conversations, one with project lead Simon Galperin (notes and analysis here) and two with members of the Bloomfield Information Project team (notes forthcoming).

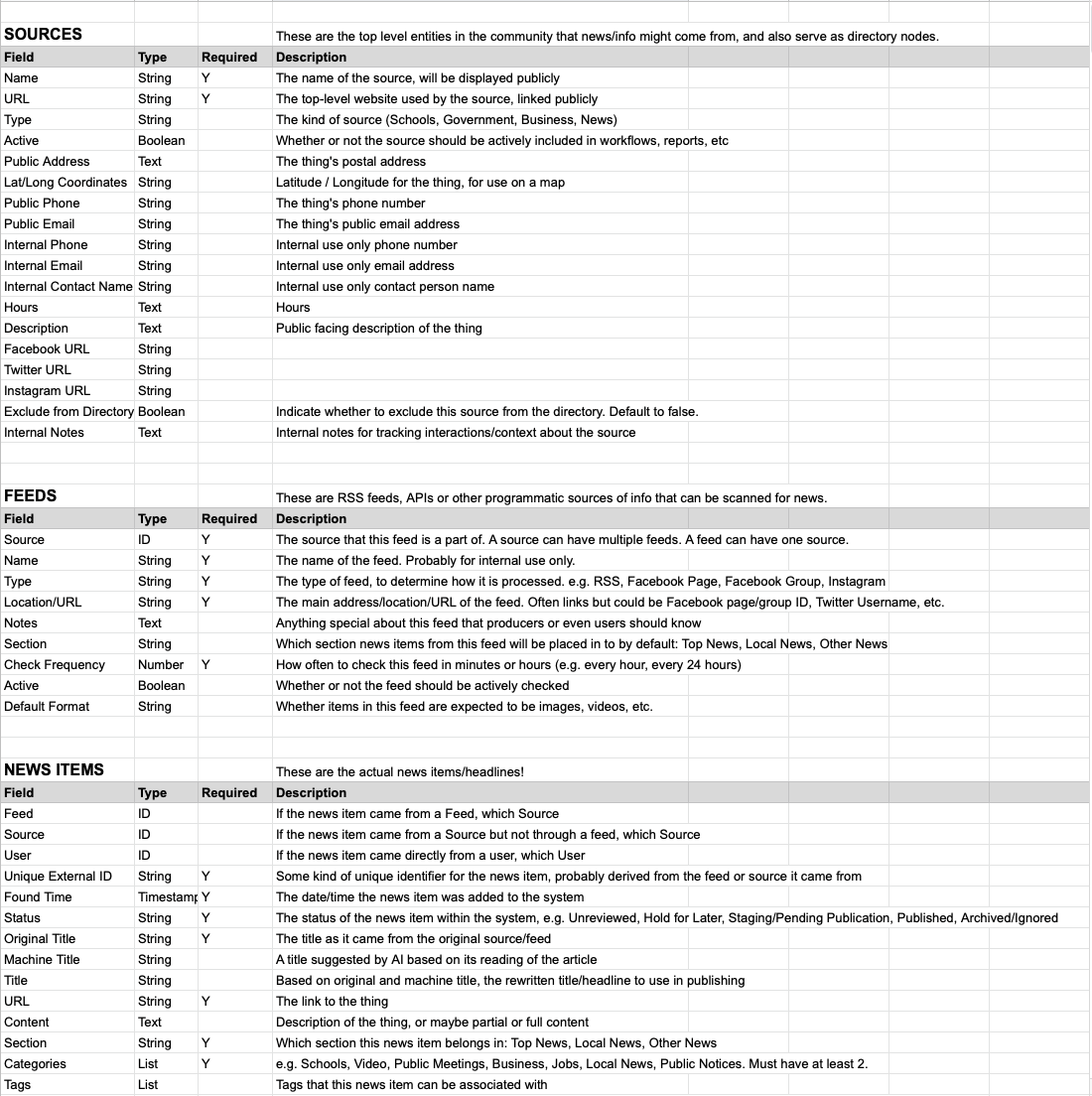

- I developed an initial data model for organizing the information that the new software tool will use and manage, reviewed it with Simon, and made some refinements based on feedback.

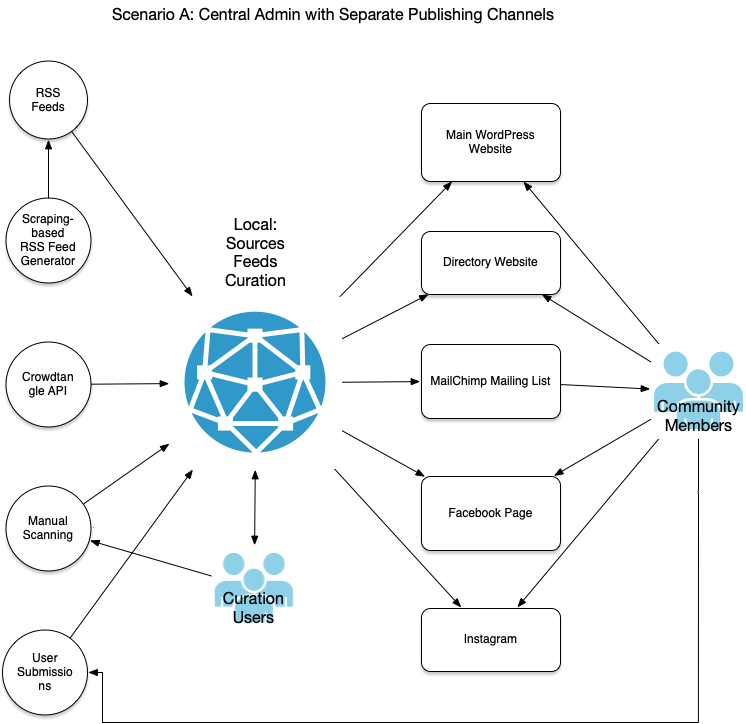

- I posted related notes about a conversation and subsequent decision about the structure of the new application.
- I began working on wireframe mockups of the new application, and am working to finish those for presentation and discussion.
Plans
- Continue working on the wireframe mockups for the new application, and present those to the Bloomfield team so I can refine and finalize them. I expect to have them done this week (by March 4th).
- Continue with stakeholder interviews, at least one representative reader of the Daily Bulletin, and one person who has provided (individually or as a part of an organization) financial support to the project. Simon is connecting me with those individuals and I hope to have those completed this week or next (by March 11) pending availability of the stakeholders.
- Begin software development! It’s almost time to start building the new tool, with hopes of delivering an initial version for testing before the end of March. This will consume most of my time on the project in the weeks and months ahead.
Problems
We are a bit behind the timeline I’d originally imagined, but at this point there are no problems or concerns affecting the overall progress of the project.
